Violation of Deadlines and Phasing of Design Works
Date:
11.09.2026
Reading time:
18 minutes
FAQ
What should be done in case of a negative expert opinion on design works?

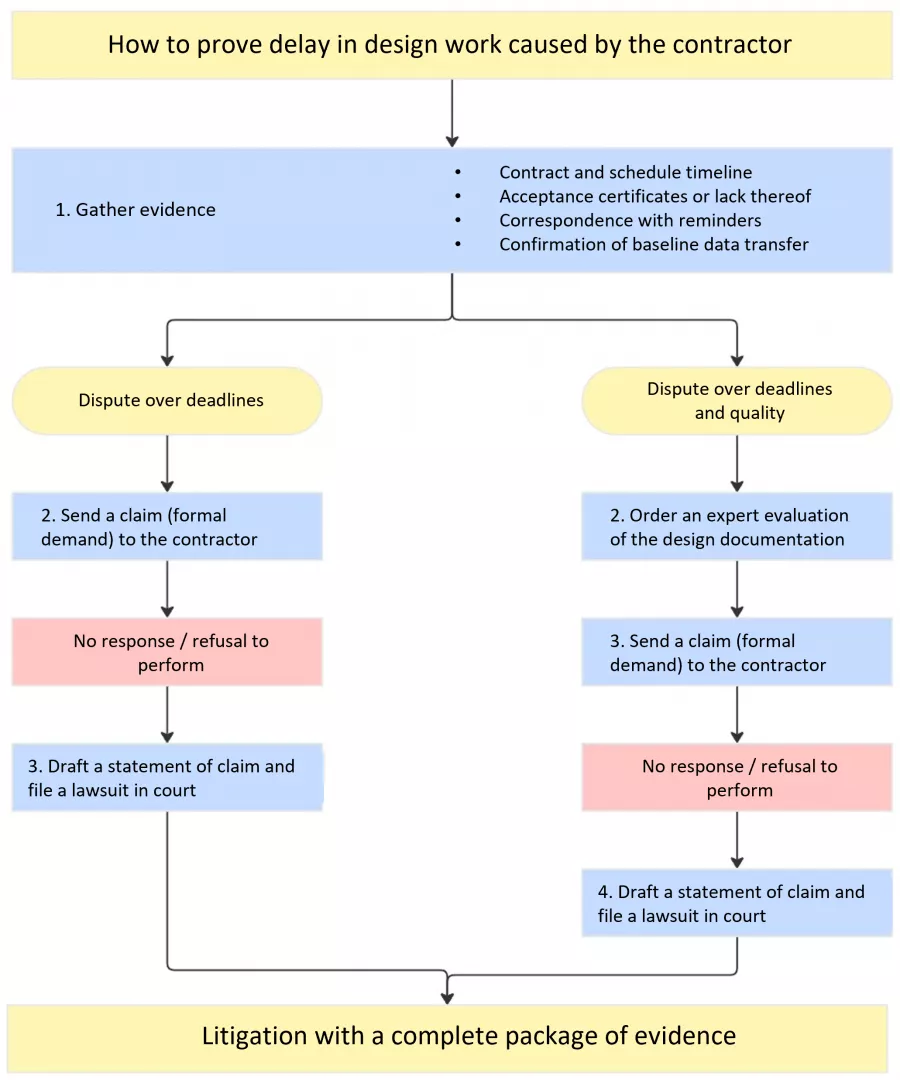

What documents does the client need to prove the contractor’s fault in delay of design works?
If the client accepted delayed design works, does the right to sanctions remain?
Is it possible to recover damages in excess of the contractual penalty or late fees under Federal Law No. 44-Federal Law?
How does a contractual penalty under the Civil Code differ from late fees under Federal Law No. 44-Federal Law?
What grounds are considered valid for extending deadlines for design works?

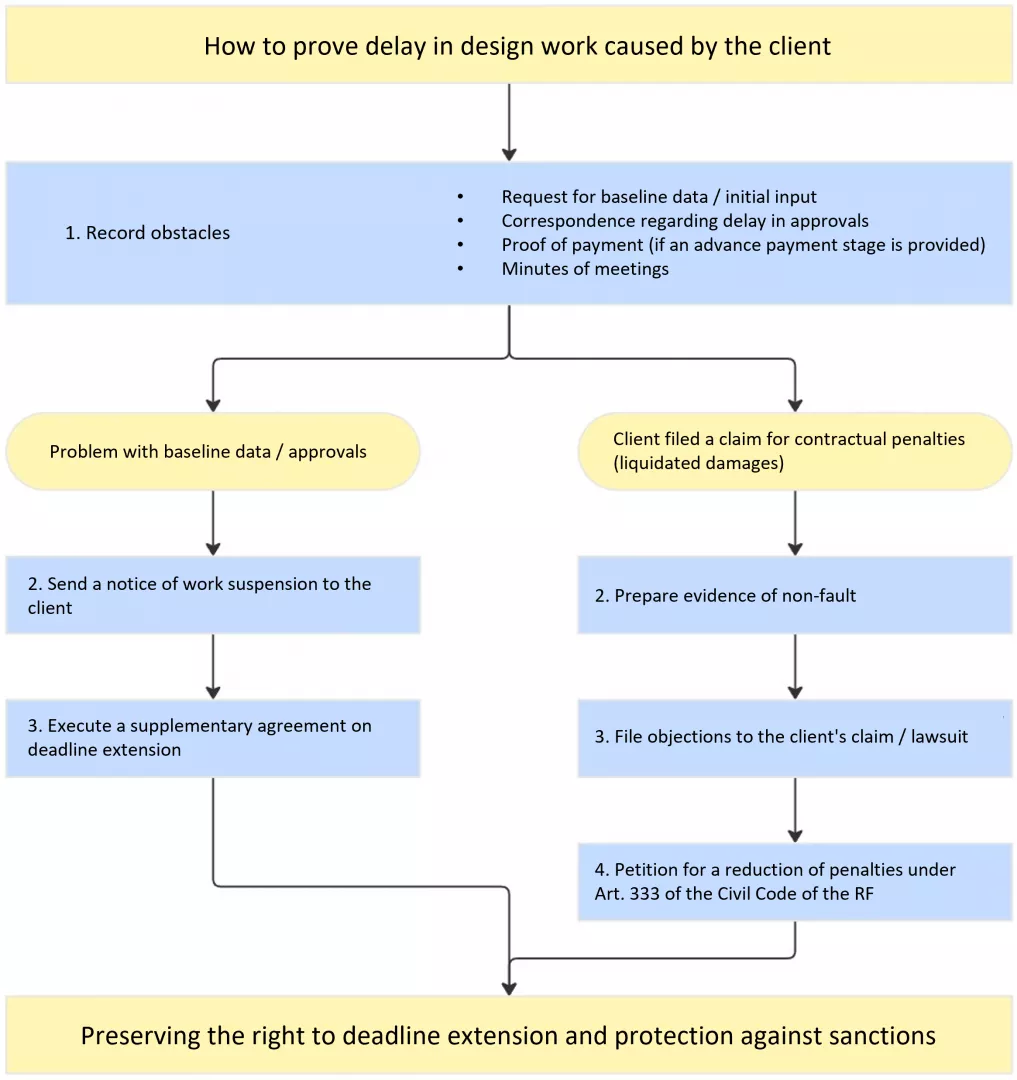

Is it possible to extend the design deadline without an addendum?
Key Terms
D
Design Documentation
Related articles
All articles
Liability for Defects Identified During the Project Implementation Stage
When defects are identified during the project implementation stage, the key issue becomes determining who is responsible for them. Unlike everyday disputes, where identifying the responsible party is simpler, construction projects involve several participants, each responsible for their own scope of work.
The designer is responsible for the accuracy of the design documentation. Even if the documentation has undergone expert review and received a positive conclusion, this does not exempt the designer from subsequent liability. If errors in calculations, inconsistencies in drawings, or violations of technical regulations are discovered during construction, the designer must revise the documentation and compensate the customer for damages.
Violation of Deadlines and Phasing of Design Works
In accordance with the Civil Code of the Russian Federation, the condition on deadlines for performing design works is mandatory: the contract must specify the start date, the final date, and intermediate stages.
The Urban Planning Code of the Russian Federation establishes the staged nature of preparation of design documentation and the mandatory nature of its expert review.
In state and municipal contracts, deadlines are always classified as essential terms; their modification is possible only in cases expressly provided for by Federal Law No. 44-Federal Law and Federal Law No. 223-Federal Law.
Who bears liability for violation of deadlines and what consequences await the parties to the contract are examined in this article.
